Page 12 - Azerbaijan State University of Economics
P. 12

THE JOURNAL OF ECONOMIC SCIENCES: THEORY AND PRACTICE, V.75, # 1, 2018, pp. 4-15


                    the integrated planning period: quarter and month. In depending on the duration of
                    the production cycle of two productions:

                        a) Formed  by  a  linear  programming  problem  must  determine  xit  –number  of
                           products i-th type, released into  t-th month, under constraints: on the number
                           of products by months      ≥    ,    = 1,12		   =   ,   ,	bandwidth equipment
                                                           /T
                                                     /T
                           ∑    .    <    	,    = 1,2			   =   ,   	,  where  Nit  –  minimum  monthly  volume
                               /.
                                   /T
                                        .T
                             /
                           of production output i-th type;  Tij – complexity of manufacturing i-th type of
                           products  into j-th type  of  the  equipment’s;  Pjt  – fund  of working  time j-th
                           type  of  equipment  into  t-th  month.  As  a  creation  can  be  act:  uniform
                           lo9ading  equipment     = ∑  J  |   − ∑ J        | →       ,  where  Tt  –  the
                                                  2
                                                             T
                                                                       / /T
                                                                  /62
                                                        /62
                           average  complexity  of  manufacturing  all  products  included  to  production
                           program.    t-th  month,  Ti  –full  complexity  of  manufacturing  i-th  type,
                           deviation  in  value  monthly  production  program  from  planned;  at  least  the
                           total number of  files,  produced  in a  month. Mathematical  apparatus of  the
                           synthesis of such models is a mathematical programming.

                        b) Cycle of manufacturing products for more planning time, as a result of the
                           solutions of sharing scheduling generalization of the areas assigned to certain
                           discrete interval time. In this statement uses the following methods: network,
                           calculation of timing the start of production in relation to output. Scheduling
                           model  used  scheduling  theory.  An  example  of  which  model,  is  the  model
                           used for the Jonson problem:  machined parts m, technical and technological

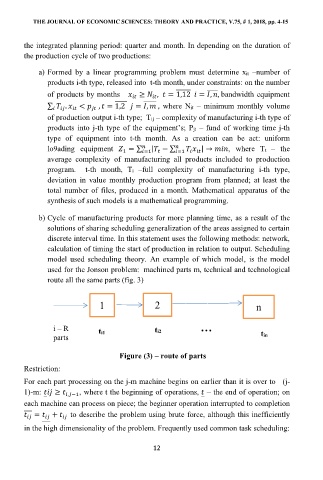

                           route all the same parts (fig. 3)


                                           1                2                              n

                                                                          …
                             i – R
                                                            ti2
                                                                                            tin
                                           ti1
                             parts                                        ….

                                                 Figure (3) – route of parts

                    Restriction:

                    For each part processing on the j-m machine begins on earlier than it is over to   (j-
                    1)-m:        ≥    /,.12 , where t the beginning of operations,    – the end of operation; on
                    each machine can process on piece; the beginner operation interrupted to completion

                       =    +     to describe the problem using brute force, although this inefficiently
                     /.
                          /.
                                /.
                    in the high dimensionality of the problem. Frequently used common task scheduling:
                                                           12
   7   8   9   10   11   12   13   14   15   16   17
